How Much Does It Cost To Build A Parking Lot In 2026?

In 2026, a new U.S. surface parking lot typically requires a preliminary construction budget of $3,000–$8,000 per space, or $300,000–$800,000 for 100 spaces, before land acquisition and project-specific extras. A conventional parking garage is substantially more expensive: WGI’s 2026 national median construction benchmark is $33,300 per space.winsparking+1

The professional approach is to separate pavement costs, complete facility construction, total development costs, and long-term ownership costs. For land-constrained projects, TheAutomatedParkingCompany.com also offers mechanical stackers, semi-automated puzzle parking, and fully automated systems that should be evaluated alongside conventional parking during early design.

Surface parking construction costs

1. How much does a parking lot cost in 2026?

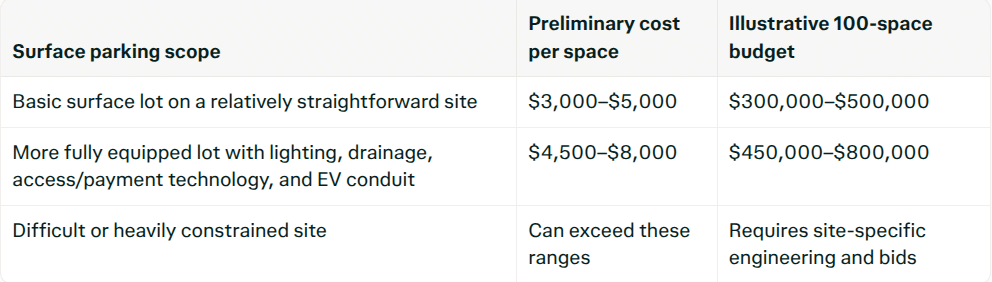

For initial feasibility planning, use the following ranges—not as contractor quotes, but as starting points for a site-specific estimate:

The first two ranges come from a published 2026 contractor guide. Difficult soils, extensive drainage, utility work, and regional construction conditions can push a project beyond those allowances.

A usable parking lot involves considerably more than laying asphalt. Its construction scope can include clearing, grading, soil stabilization, aggregate base, pavement, storm drains, detention or treatment systems, curbs, lighting, striping, signs, and access-control equipment.

Ask whether the estimate also includes:

  • Surveying, geotechnical investigation, and civil engineering.

  • Permit fees, plan review, and applicable utility or impact fees.

  • Testing, inspections, erosion control, and construction traffic control.

  • Utility relocation and off-site improvements.

  • Financing and carrying costs.

  • A construction contingency.

Published guidance recommends a 10%–15% construction contingency for new work, with larger allowances where subsurface conditions or reconstruction scope are uncertain. Land acquisition should remain a separate line item rather than disappear inside a “cost per space.”

2. What is the average cost per space?

A useful preliminary allowance is approximately $4,500–$6,800 per completed surface parking space, including paving, drainage, striping, lighting, signage, and basic technology. However, that is a contractor-published planning range—not a verified statistical national average covering every market and project type.

For example, a 100-space lot at an illustrative $5,500 per space produces a $550,000 construction allowance. You would then reconcile that allowance against the actual scope and add any excluded development costs.

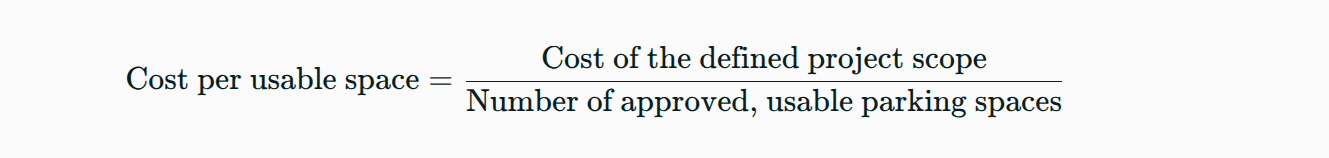

The correct calculation is:

The denominator matters. Drive aisles, accessible routes, landscaping, drainage facilities, and setbacks occupy land without necessarily adding parking spaces. Surface parking commonly consumes approximately 300–400 square feet per space when circulation is included, meaning 100 spaces can require roughly 30,000–40,000 square feet before additional site-specific requirements.

Be cautious about very low advertised prices. An asphalt-only or resurfacing estimate is not comparable to a complete new parking facility with earthwork, drainage, electrical infrastructure, and approvals. Published paving estimates vary substantially with what the contractor includes.

Ramps Are for Skateparks, Not Multi-Million Dollar Developments

3. What drives construction cost most?

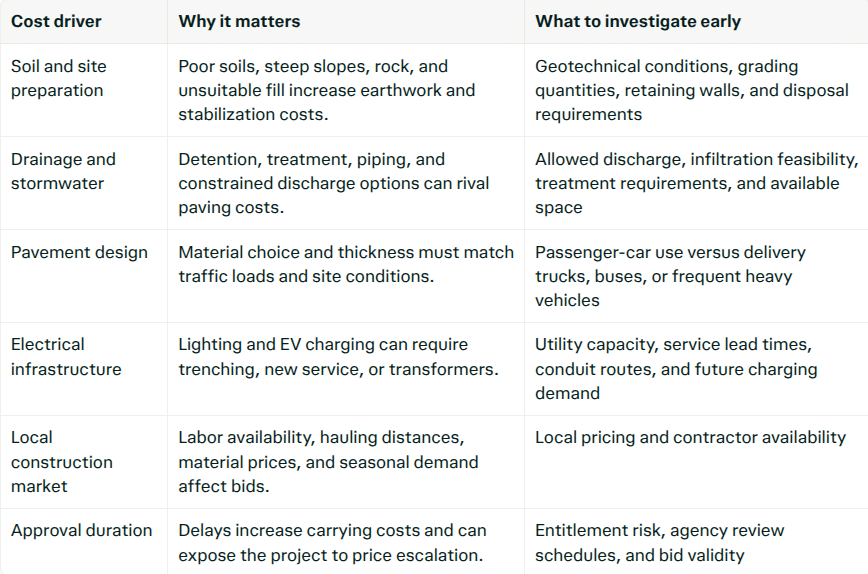

For surface parking, the biggest uncertainties are often what happens below the pavement and where stormwater must go—not the painted parking lines. The principal drivers are:

These drivers are identified in the 2026 construction guide; their relative importance varies by site.

For a developer, land also deserves separate attention. Surface parking may have the lowest construction cost while still being the least attractive use of a valuable development parcel. Compare the parking alternatives against the value of the land they occupy—not just the cost of asphalt versus equipment.

The 0k-Per-Spot Trap: Why Vertical Lift Parking Cost Less and is the 1-3 Year Depreciation Play for Smart CRE Investors. Conventional Parking Garage Structures Cost Around 0,000 per parking spot, wastes a lot of space and takes up to 29 years to depreciate the return on investment not to mention is less profitable in the long term because of maintenance expenses than vertical lift paring systems such as puzzle parking and car stackers and not as efficient as Robotic Parking Systems From The Automated Parking Company

Garage costs and alternatives

4. How much does a garage cost per space?

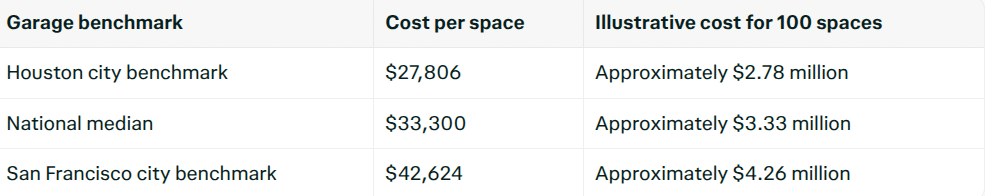

WGI’s 2026 national median construction benchmark is $33,300 per parking space, equivalent to $98.75 per square foot. Its published city examples range from $27,806 per space in Houston to $42,624 in San Francisco. These are benchmark costs, not guaranteed bids or maximum prices.

Figures are based on WGI’s published 2026 construction benchmarks. A small 100-space garage may not achieve the same economics as the projects underlying the benchmark, so multiplying the median by the space count is only an early feasibility exercise.

Garage costs rise with foundations, structural configuration, façade requirements, EV infrastructure, and fire-protection requirements. Underground parking adds excavation, shoring, waterproofing, drainage, and ventilation, so an above-ground benchmark should not be applied directly to a basement garage.

For a land-constrained property, consider three options rather than just two:

  • Surface parking.

  • A conventional ramped garage.

  • Mechanical, semi-automated, or fully automated parking.

TheAutomatedParkingCompany.com offers double, triple, and quad mechanical stackers, puzzle parking configurations from two to seven levels, and fully automated solutions. Its website also provides a parking ROI calculator for preliminary comparisons.

Compare these alternatives on an equivalent scope: foundations, equipment, enclosure, utilities, fire protection, approvals, commissioning, maintenance, staffing, and usable capacity. A mechanical system’s equipment price should not be compared with an all-in garage development budget. TAPCO notes that its mechanical stackers typically require attendants, while its puzzle systems provide independent user access—an important operating-cost distinction.

There is no defensible universal percentage saving for every automated parking project. Obtain a project-specific proposal and evaluate both the construction budget and the value of any land or building area recovered.

Three Cars, One Spot: How Triple Car Stackers Reclaim Your Land for Better Amenities

Schedule and phased construction

5. How long does a 100-space lot take?

Allow approximately four to eight weeks for physical construction of a relatively straightforward 100-space surface lot after design, approvals, and site readiness. The complete project—from design and permitting through commissioning—takes longer.

One published Colorado design-build example allows 14–22 weeks from contract to commissioning, including six to ten weeks for design and permitting. That is a regional example, not a national guarantee.

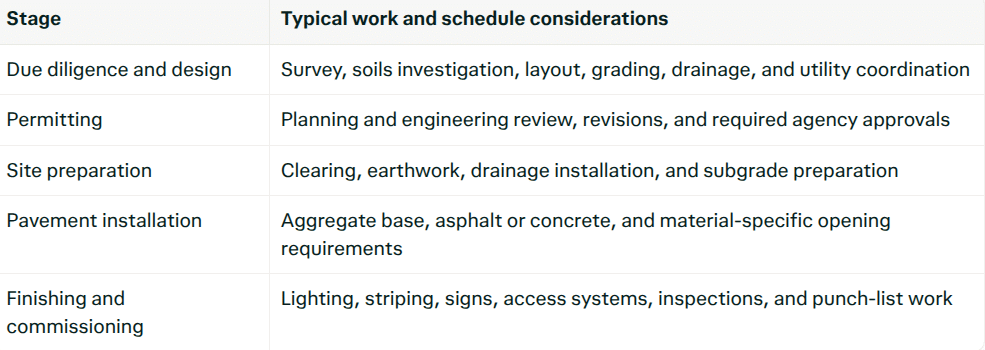

A practical schedule separates the work into stages:

The cited construction guides describe these activities and identify permitting, site preparation, paving, electrical work, and commissioning as separate schedule components. Some can overlap; others depend on preceding work.

The professional answer should distinguish “construction starts to opening” from “project conception to opening.” Weather, soil corrections, utility coordination, and approval revisions can materially change either schedule. Concrete also has different curing and opening requirements from asphalt.

Looking for a Car Parking Solution? The Main Things Developers Should Know Before Breaking Ground

6. Can construction be phased?

Yes. Parking construction can be phased over multiple years, but the final facility should be master-planned before the first phase is built. Phasing reduces the initial capital requirement; it does not necessarily reduce total cost. Repeat mobilization, inflation, and work around an operating facility can increase the eventual expenditure.

A sensible sequence is:

  1. Design the ultimate layout, drainage, utilities, and expansion strategy.

  2. Build the first usable phase with required pavement, access, accessibility, drainage, and safety features.

  3. Install underground conduit and other difficult-to-retrofit infrastructure during initial earthwork.

  4. Add discretionary payment technology or additional EV chargers as demand supports them.

  5. Expand capacity or add other improvements under the approved master plan.

This follows the published guidance to construct durable, hard-to-retrofit elements first and defer easier additions where appropriate.

Do not treat required accessibility, stormwater controls, or other opening conditions as optional future upgrades. The approval package must establish what each operating phase requires.

If future capacity could involve car stackers or puzzle parking, involve The Automated Parking Company during concept design so the team can evaluate dimensions, foundations, electrical requirements, and operational fit before the site is built around a conventional layout. TAPCO offers customized design and engineering for its systems.

How Lack of Parking Can Cost Developers and Their Tenants Millions: Lessons from San Jose's Vietnam Town

Permits and approvals

7. What permits are required?

There is no single nationwide “parking lot construction permit.” The applicable approvals depend on the municipality, proposed use, grading, drainage, utilities, and whether the facility includes structures or mechanical parking equipment.

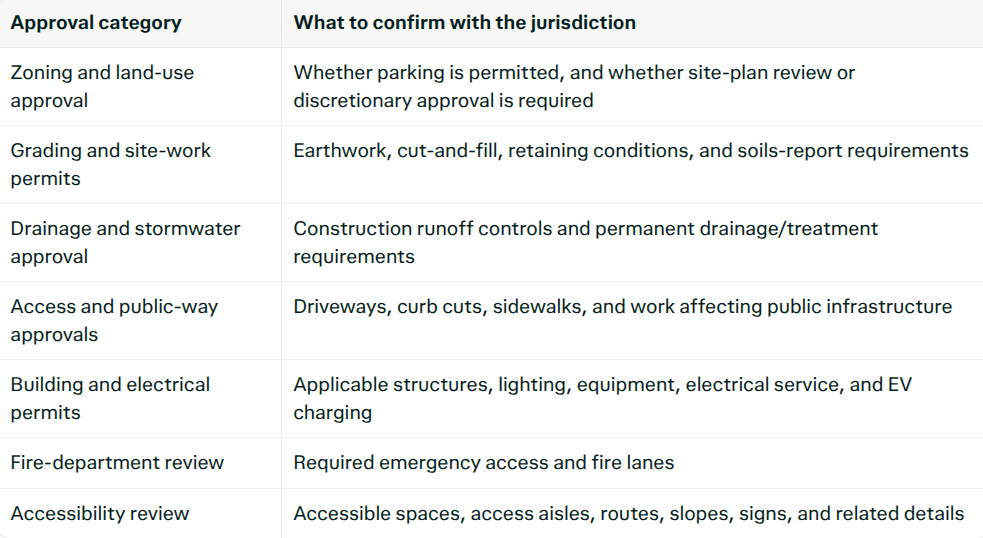

Use this as a coordination checklist—not a statement that every item applies everywhere:

Published construction guidance identifies zoning, engineered plans, stormwater permits, and fire review as important approvals. Los Angeles also publishes parking-design and grading requirements, illustrating why a local code review is essential.

A particularly important federal threshold is construction stormwater coverage. EPA states that regulated construction stormwater discharges generally require NPDES permit coverage when activity disturbs one acre or more, or less than one acre when part of a larger common development plan that ultimately disturbs at least one acre. Applicable coverage and documentation may be administered through the state rather than EPA directly.

Phasing a project into smaller sections does not automatically avoid that common-plan requirement.

For Los Angeles County projects, check permanent stormwater requirements early as well. The county’s Low Impact Development manual identifies parking lots of at least 5,000 square feet or 25 parking spaces among its relevant project categories; applicability depends on the project and governing jurisdiction.

Maintenance and ownership costs

8. What maintenance should I budget?

Budget for both annual upkeep and periodic capital renewal. A parking lot can look inexpensive to operate in its first year while accumulating a substantial future pavement liability.

The main categories are:

  • Pavement inspections, crack sealing, pothole repairs, and localized patching.

  • Periodic sealcoating where appropriate for the asphalt surface.

  • Restriping and replacement of worn markings and signs.

  • Sweeping, debris removal, and drain cleaning.

  • Landscape and irrigation maintenance.

  • Lighting and electrical repairs.

  • Payment, access-control, camera, and communications-system support.

  • Snow and ice control where applicable.

  • A reserve for resurfacing or eventual reconstruction.

Published maintenance guidance emphasizes crack repair, sealcoating, patching, and restriping; the parking construction guide also identifies lighting, drainage, and technology as facility components that must be considered over the asset’s life.

For a concrete cost reference, one 2026 contractor guide quotes sealcoating a 50,000-square-foot commercial lot at $11,000–$19,000, or approximately $0.22–$0.38 per square foot. Crack sealing, pavement repairs, and striping can be additional.

At that same illustrative unit rate, sealcoating a 35,000-square-foot lot would cost approximately $7,700–$13,300 per application. The actual maintenance cycle should reflect pavement condition, traffic, climate, and local specifications rather than an automatic annual treatment.

For longer-term renewal, a Southern California contractor publishes current pricing of approximately $3–$5 per square foot for a two-inch overlay and $5–$8 per square foot for four-inch full removal and replacement. These are local contractor figures, not nationwide rates, but they demonstrate why a separate pavement reserve matters.

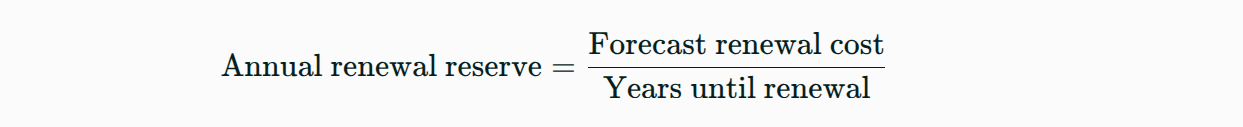

A useful reserve method is:

For example, an illustrative $140,000 rehabilitation expenditure expected in ten years would require $14,000 per year before inflation and investment earnings. That is a budgeting example, not a prediction of your lot’s service life.

Keep maintenance separate from broader operating expenses such as electricity, insurance, taxes, staffing, payment-processing fees, and debt service. Otherwise, “maintenance per space” becomes misleading.

For mechanical or automated parking, request a written service proposal covering preventive maintenance, inspections, parts, controls, emergency response, and replacement reserves. The Automated Parking Company states that it services its systems and provides ongoing support, but a property-specific maintenance agreement—not a generic claim of low operating cost—should support the ownership budget.

Automated Parking Solutions in Dense Urban Development: A Strategy for Maximizing Land Value, Density, and Municipal Revenue

Car Stackers and Puzzle Parking: A Faster, Smaller-Footprint Alternative

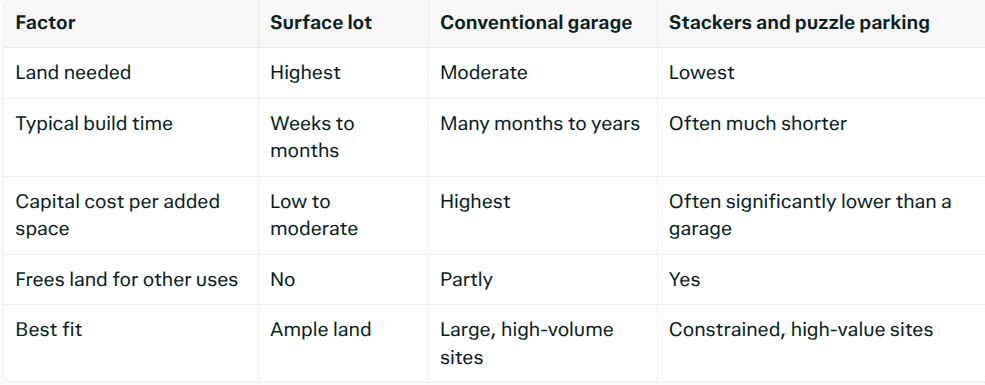

When a project needs more parking than the site can hold, building a bigger lot or a conventional garage is not the only option. Car stackers and puzzle parking systems can add capacity faster, on less land, and often at a lower cost per added space than ground-up garage construction. They can also free land and building area for other uses.

Why conventional parking gets expensive

A surface lot spreads cars across a large area. A new garage adds foundations, ramps, structure, façades, fire protection, and a long design and permitting process. A conventional garage is a major capital project. WGI’s 2026 national median benchmark is $33,300 per space, and a stacker or puzzle system is often a smaller, faster project.

Car stackers: more cars in the same footprint

Mechanical car stackers lift one vehicle above another. Double, triple, and quad configurations can multiply capacity within an existing footprint.

  • Less space: A double stacker roughly doubles the cars in a stall, and triple and quad configurations go further.

  • Faster delivery: Stackers are installed as equipment on a prepared slab or pit, so they avoid much of the multi-month structural work of a new garage.

  • Lower capital cost: Added spaces can come at a fraction of the per-space cost of a new structure. The savings depend on the site, configuration, and scope.

  • Operating profile: Stackers typically work best with attendants or known users, such as residents, employees, and fleets.

Puzzle parking: independent access in a compact footprint

Puzzle parking systems arrange vehicles on pallets that shift sideways and up and down, like a sliding-tile puzzle. They run from two to seven levels.

  • Independent access: Each user can retrieve a car without an attendant, which suits multifamily, office, hotel, and mixed-use projects.

  • Compact footprint: Vehicles are stored in a dense grid with no ramps and no wide drive aisles.

  • Scalable capacity: Systems are configured to the site, and many fit inside a building envelope or an underground level.

Space freed for other uses

Dense parking is not only cheaper per space. It also gives back land and floor area.

  • Parking that takes less ground area leaves room for amenities such as courtyards, pools, fitness areas, and outdoor dining.

  • It can leave room for additional units or leasable space, which raises project revenue.

  • It can reduce excavation depth or the number of garage levels, which cuts cost and schedule risk.

  • It can make an infill or constrained site workable that would otherwise fail on parking requirements.

Compare total project value, not just equipment price

A fair comparison counts the same scope on each side: foundations, equipment, enclosure, utilities, fire protection, approvals, commissioning, and maintenance. It also counts the value of the land and building area recovered. On high-value sites, that recovered space can matter as much as the construction savings.

Get a project-specific proposal

TheAutomatedParkingCompany.com offers mechanical stackers, puzzle parking systems, and fully automated parking. Its website includes a parking ROI calculator for early comparisons. To see whether stackers or puzzle parking can give you more spaces, a faster schedule, and room for other amenities, request a quote based on your site dimensions, vehicle mix, and user type.
